AI infrastructure investment has moved upstream. The advent of ChatGPT, Claude and other AI applications fueled demand for semiconductor chips that enable the software to “think.” The demand concurrently brought about record capital expenditures to build out hyperscale data centres housing those chips. Now the bottleneck is even more basic: power. For AI, electricity is no longer a utility input; it is strategic infrastructure.
Data centre growth needs energy – a lot of it

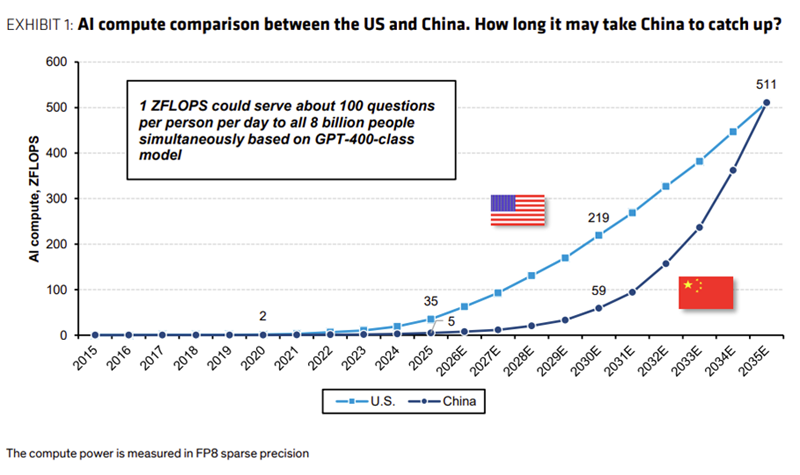

That shift is colliding with a US grid whose expansion is constrained at multiple points: new generators are stuck in interconnection queues; interstate transmission still requires approvals across multiple jurisdictions; transformer shortages are delaying grid upgrades; and local opposition is increasingly slowing or cancelling data centre projects. North American Electric Reliability Corporation’s 2025 long-term reliability assessment warned that 13 of 23 North American assessment areas face resource-adequacy challenges over the next decade, underscoring that the issue is not only energy volume, but deliverability and reliability.

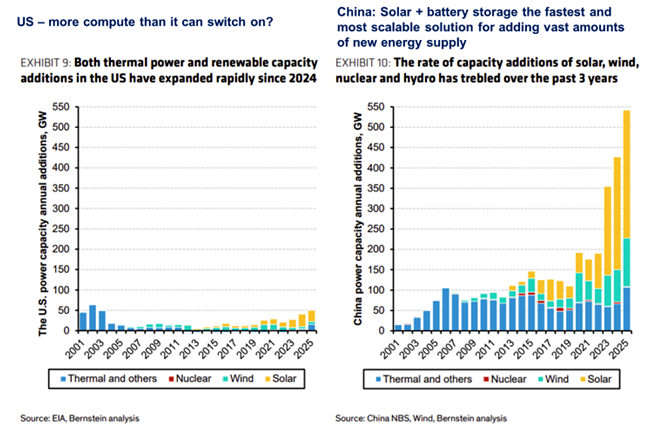

Electric Power Research Institute’s Powering Intelligence 2026 report makes the same point from the data centre side. Its “Generation and Capacity Impacts of Data Center Load” analysis finds that data centre growth could require large additions of generation and transmission capacity, but that supply-chain, siting and permitting constraints may limit how fast those additions arrive. In least-cost scenarios, incremental data centre load is met primarily by new and existing gas generation rather than carbon-free resources.
Getting power to where it’s hard to get
That naturally explains the recent order flow into large reciprocating engines. In April, the Finnish vessel engine manufacturer Wärtsilä Oyj Abp announced a 790 MW off-grid power solution for a new Texas data centre facility, using its 50SG natural gas engines. Wärtsilä explicitly framed the order around fast access to reliable power in a region where the grid cannot adequately meet urgent AI-infrastructure demand. Around the same time, the Korean shipbuilder HD Hyundai Heavy Industries Co. Ltd. disclosed that it had signed a US data centre power generation equipment contract based on its 20 MW-class HiMSEN engines, citing total capacity of 684 MW.
The appeal is straightforward. Large reciprocating engines are modular, dispatchable, fast-starting, scalable in increments and deployable closer to load than central-station plants. Compared with combined-cycle gas turbines, nuclear projects or major transmission upgrades, they can often be installed in shorter phases and avoid waiting years for grid interconnection. For a data centre developer, speed-to-power can be as important as cost-of-power.
Maintaining engine power at sea and on land
HD Hyundai Marine Solution Co. Ltd. (443060 KS) in our Emerging Markets Small Cap Strategy is the sole authorized provider of maintenance, repair and overhaul (MRO) aftermarket services to HiMSEN engines worldwide. As a HD Hyundai-affiliate, the company benefits from having HD Hyundai Heavy Industries – the world’s second largest shipbuilder and the largest manufacturer of medium-speed 4-stroke vessel engines – as a captive market. Of approximately 17,000 HiMSEN units in operation globally (most of them generating power for over 4,000 ships at sea), roughly 2,000 units are generating power on the ground.
Could data centres move offshore?
Mitsui O.S.K. Lines and Karpowership’s Kinetics have already signed a memorandum of understanding to develop what they describe as the world’s first integrated floating data centre platform, hosted on a retrofitted vessel and supplied by a powership capable of using LNG. In that scenario, vessel-engine makers are also powering the physical layer of AI.
